Project Progress Analysis As Hinkley Point Application Made

This is entry number 291, published on 2 November 2011, of a blog on the Planning Act 2008 infrastructure planning and authorisation regime.

United KingdomReal Estate and Construction

This is entry number 291, published on 2 November 2011, of a blog on the Planning Act 2008 infrastructure planning and authorisation regime. Click here for a link to the whole blog. If you would like to be notified when the blog is updated, with links sent by email, click here.

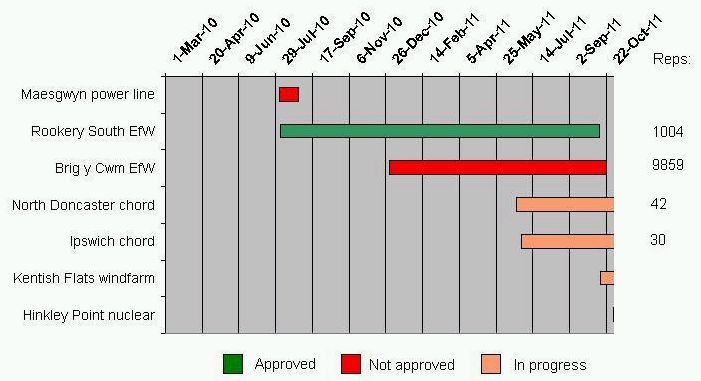

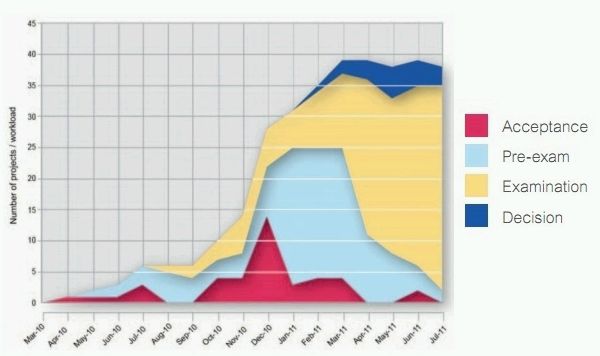

Today's entry examines progress on applications as the latest, for the Hinkley Point nuclear power station, is made.

Hinkley Point application

On Monday, the Infrastructure Planning Commission (IPC) received the long-awaited (and incorrectly pre-empted by Chris Huhne a couple of weeks ago) application from EDF Energy for a new nuclear power station at Hinkley Point in Somerset. This is the first application for a nuclear power station, and the first that will produce more than 100MW of additional electricity - over 3000MW, in fact. Although it gets more Google hits with a 'c' than without, Hinkley doesn't have one - but it will be Hinkley Point C nuclear power station.
